Team Overview: The Monthly Attendance and Overtime Report
The Report — month tab of the Team Overview page is an automated monthly attendance and overtime report for your whole team: worked and missed work days, attendance percentage, regular hours, work-day and day-off overtime — the sheet many managers build by hand every month, generated for you. It always covers the current month through yesterday (today, still in progress, is excluded), and it consists of three tables.
Requiring attention

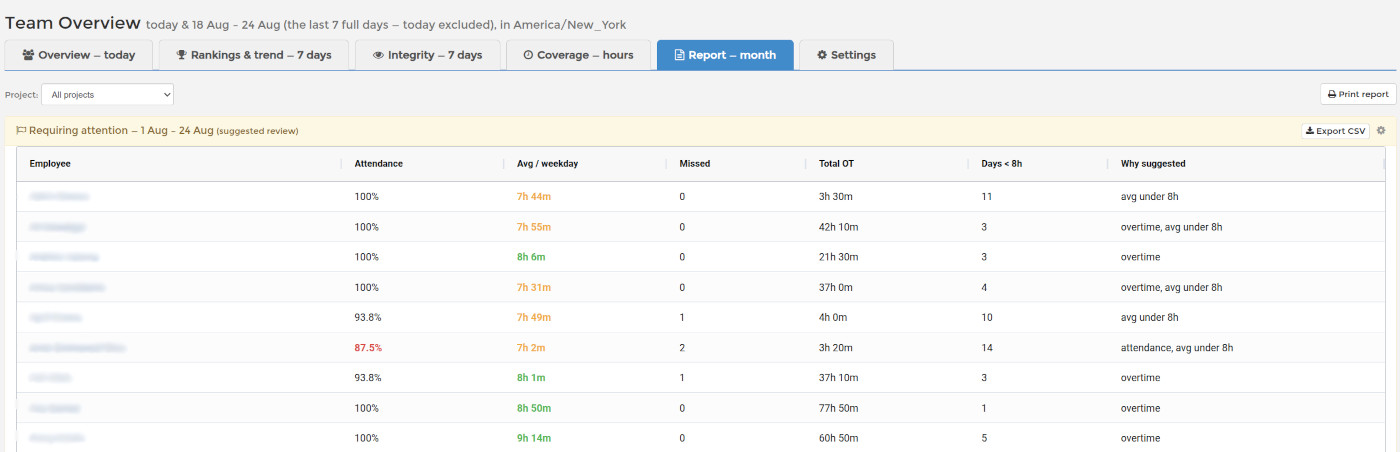

The first table lists only employees the built-in heuristics suggest reviewing, with the reason spelled out in the Why suggested column: attendance below 90%, total overtime of 20 hours or more, or an average under 8h per worked day (judged only once someone has 5+ worked days). Columns: Attendance, Avg / work day, Missed (expected work days with no tracked time), Total OT and Days < 8h. These are threshold suggestions, not verdicts — someone can be legitimately on vacation, part-time, or doing agreed overtime. Verify in the work log before acting.

Day-off work
The second table lists everyone who worked on a day off this month, a weekend or a day off by their working hours, a public holiday or a day on leave: Day-off days, Day-off hours, and the share of their total monthly time that work on days off represents. It is informational — work on a day off is often agreed overtime — but it makes unpaid or unnoticed load on days off visible.
Summary — the full monthly sheet

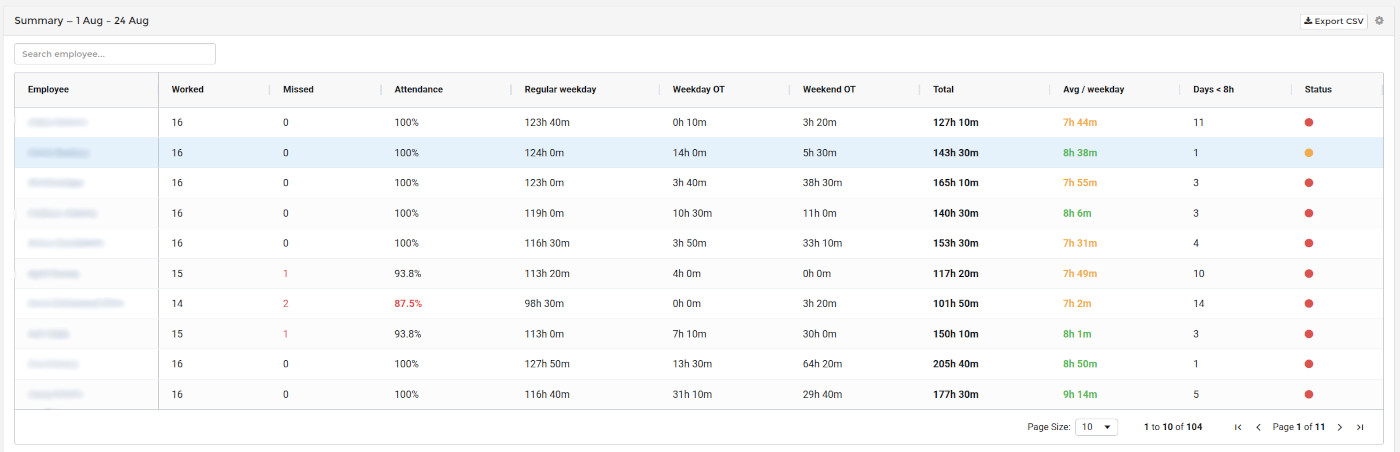

The third table has one row per employee: Expected work days (hover it to see why: holidays, leave, the join date, whose hours apply), Worked / Missed work days, Attendance %, Regular hours, Work-day OT, Day-off OT, Total, Avg / work day, Days < 8h, and a Status dot (green = nothing unusual, amber = some overtime, red = suggested review). The overtime model is simple and predictable: time beyond 8 hours on a work day counts as work-day overtime, and all time on a day off (a weekend or a day off by the hours, a public holiday, a day on leave) counts as day-off overtime. The 8-hour line stays the same whatever the working hours say. The average is honest too — work-day hours divided by work days actually worked, so day-off overtime never inflates it.

Filtering by project, printing and exporting
Use the Project selector at the top to scope the whole report to a single project: the tables then show only the employees assigned to that project, with only their hours on it — per-project attendance and overtime at a glance. An employee assigned to the project who did not work on it still appears with zeros, which is exactly what makes absences visible. Print report opens a clean printable sheet of the full report, and every table has its own Export CSV button for payroll or HR.

Which days count as work days
Since October 2026 the sheet counts the same days as the Attendance tab. An employee is expected on a day when it is a work day by the working hours you set (their own hours first, then the team hours; Monday to Friday when none are set), it is not a public holiday for the country the Holidays setting gives them, they are not on leave, and they had already joined your team. A day with nothing tracked is missed only when it was expected, so a week of leave, a public holiday or a start in the middle of the month no longer pulls the attendance percentage down.
The Expected column carries the result per person; hover it for the reasons. Work on a day that was not expected (a weekend or a day off by the hours, a holiday, a day on leave) goes to Day-off OT, shown but not judged. Working hours, holidays and leave are all set from the Attendance tab; a change shows in the sheet at the next load. An employee you deactivate leaves the sheet with their deactivation; their time stays in the work log.
Day by day: the weekly attendance grid
This report is monthly and counts days. For the day-by-day picture, who started and finished when and whether that was late or early against the working hours you set, open the Attendance tab. Read more: Team Overview: Attendance, Start and End of Work by Week.
